Hudson Harvest · 2026 Outdoor Season

Field Build Plan

Everything that has to be ordered, built, and ready in the next ~30 days to get 1,000 plants into the field on time. Written so anyone on the team can pick it up and run their part.
Plan date: June 1, 2026  |  Clones arrive ~June 15–18  |  Transplant window ~June 24–26  |  Baseline 1,000 plants (scales up or down)
▸ This week (Jun 1–7) — align the team, then lock the long-lead items
  1. Get the team on a call — confirm everyone's comfort with the plan, individual roles, time commitment & availability, and that the project is a go before committing spenddo first
  2. Talk irrigation with Alec, then get quotes from Soilscape, RainFlo & Netafim and build the buy listmost urgent
  3. Book soil delivery now — Vermont Compost + McEnroe (quoted); 2–3 wk lead vs the Jun 24 transplant
  4. Order 45-gal pots (1,030)
  5. Order grow tents + LED + climate kit
  6. Order the prop-house tunnel + shade clothby ~Jun 6

Order-by dates — not need-by — are what matter now. Full timeline in §1.

At a glance — who owns what, and when (full detail in each section)
ProjectOwner(s)Order / engage byReady by
P1 · Warehouse + tentsMax (Marco teams)This week~Jun 14
P2 · Prop houseMax + Marco; Alec (structure)~Jun 6~Jun 20
P3 · IrrigationAlec (lead) + Soilscape/RainFlo/NetafimScope w/ Alec now; parts ~Jun 9Before transplant
P4 · Pot matrixMax + all-hands; Alec (tractor)This week~Jun 24
Trellis + deer fenceMax + Marco; Alec (layout)~Jun 9By transplant
Standing roles
PersonRole
MarcoHead of Resin Quality Management — trichome monitoring, harvest-timing advice, fresh-frozen optimization. Teams with Max on the build.
StevenRemote monitoring & crop nutrition.
Athena Ag (Brett & Owen)Advisors — nutrient & pest/disease protocol, spacing, fill-system guidance.
How to read this document Numbers, sizes, and climate settings here are starting points drawn from cited industry sources and Athena Ag's protocol — not final specs. Every one is a rough heuristic for the team to discuss; the named owner of each project is responsible for checking it, dialing it in to our actual site and genetics, and signing off before money is spent. Prices are rough planning estimates from web research dated June 2026 unless a vendor quote is noted — treat them as budget-scale, not quotes.
0 · How the four projects fit together 1 · The timeline (start here) 2 · Field plan drawing 3 · Project 1 — Warehouse & grow tents 4 · Project 2 — Propagation house 5 · Project 3 — Irrigation & fertigation 6 · Project 4 — The 45-gallon pot matrix 7 · Trellis, tractor access, deer fence, cold-frame 8 · Spray program & plant health 9 · Genetics selection 10 · People, hours & hiring 11 · Security, monitoring & data 12 · Equipment list & budget 13 · Most likely ways this goes wrong 14 · Open decisions to confirm

0How the four projects fit together

The whole season turns on one moment: moving rooted young plants out of small pots and into the field. That is the transplant. Everything below exists to make that moment happen on time and without scramble.

The plants travel through four places, in order:

  1. The warehouse — small starter plants ("clones") arrive ~June 15–18 and recover under lights in grow tents for a few days.
  2. Up-potting — they move into 4-inch pots and settle.
  3. The propagation house — a covered hoop tunnel just outside the warehouse where they "harden off," adjusting to outdoor sun and air under shade cloth until their roots fill the 4-inch pot.
  4. The field — once roots show through the bottom of the 4-inch pot, they are transplanted into 45-gallon pots already filled with soil and hooked to water.
The one rule that controls the schedule We transplant when roots show through the bottom of the 4-inch pot — the plant decides, not the calendar. The whole field side (irrigation + filled pots) must be 100% finished before that happens, so plants never sit waiting on us. If the field is late, the plants get root-bound and stressed, and the season starts on the back foot.

The four build projects run in parallel, not one after another. Projects 1 and 2 carry the plants through their early life; Projects 3 and 4 prepare the field to receive them. The timeline below shows how they overlap and where they must converge.

1,000
Plants (baseline)
~16
Rows @ 200 ft
~190
Cu yd soil (85% fill)
~1.2–1.4
Acres incl. aisles
~30
Days to ready
Scaling the whole plan up or down Every quantity is built on a per-plant rate, so any plant count recomputes cleanly. Headline rates: soil ≈ 0.19 cu yd per plant · pots = 1 per plant + ~3% spares · drip emitters = 1 per plant · rows ≈ 66 plants per 200-ft row at 5′×6′ spacing (or ~80 at the tighter 5′×5′). For 800 plants multiply by 0.8; for 1,200, by 1.2.

1The timeline — start here

Blowing the timeline is the single most likely way this season goes sideways. So timing comes first, and every project below repeats its own "order by / build / ready by" dates. Read this section before anything else.

The punchline: most procurement risk is in the next 5 business days Tents, the prop-house tunnel, soil, pots, and the irrigation design all have lead times measured in days to weeks. If they are not ordered/engaged in the week of June 1–7, they may not arrive in time to build before the plants are ready. Order-by dates — not need-by dates — are what matter now.
Task  /  WeekJun 1–7Jun 8–14Jun 15–21Jun 22–28Jun 29–Jul 5
Order / engage (long-lead)
Site & pad prep, deer fence
P1 · Warehouse + tents
P2 · Prop house
P3 · Irrigation design
P3 · Irrigation install
P4 · Soil delivered
P4 · Place + fill pots
Clones arrive → tents
Up-pot to 4″ · settle
Harden off in prop house
★ TRANSPLANT to field
Order / engage Site prep + fence P1 Warehouse P2 Prop house P3 Irrigation P4 Pot matrix Plant journey red label = on the critical path

The critical path — the chain that cannot slip

Irrigation design (engage now) → soil delivered → pots placed & filled → drip run to every potfield 100% ready★ transplant when roots show (~Jun 24–26).

The plant journey (clones → tents → up-pot → harden off) runs on its own biological clock and largely takes care of itself. The risk is all on the field side. If irrigation design slips in week one, every step behind it slips too — which is why engaging the designer is the most time-sensitive single decision in this document.

Order-by / engage-by dates for the long-lead items (the week-one list)
ItemWhy it has lead timeOrder / engage by
Irrigation designDesign must finish before parts can be ordered and laidThis week (Jun 2–6)
Soil (bulk)Vermont Compost + McEnroe quoted; book delivery now — 2–3 wk lead; ~4 loads (40–60 yd)This week
45-gal pots (1,030)Volume order may backorder or ship freightThis week
Grow tents + LED + climate kitMust arrive and be built before clones (~Jun 15)This week
Prop-house tunnel + shade clothMust be standing before plants leave warehouse (~Jun 21)By ~Jun 6
Irrigation partsOrdered right after design landsBy ~Jun 9
Deer fence + trellis materialsPerimeter and trellis go up before/with transplantBy ~Jun 9
Tractor sprayerNeeded for first preventative spray after transplantBy ~Jun 20

2Field plan drawing

A top-down schematic of the field: rows, plant pairs, the irrigation backbone, water and pump location, and the deer-fence perimeter. This is a working sketch to align on layout — not a survey.

Dimensions are placeholders — to be replaced from the real site The proportions below are illustrative. Exact field size and shape will be worked out from a marked-up site map (the garden footprint). Note the available area may be wider than older aerial images show, since more trees have since been cleared. Once real measurements are in, this drawing gets redrawn to scale and the row count / fence length update with it.

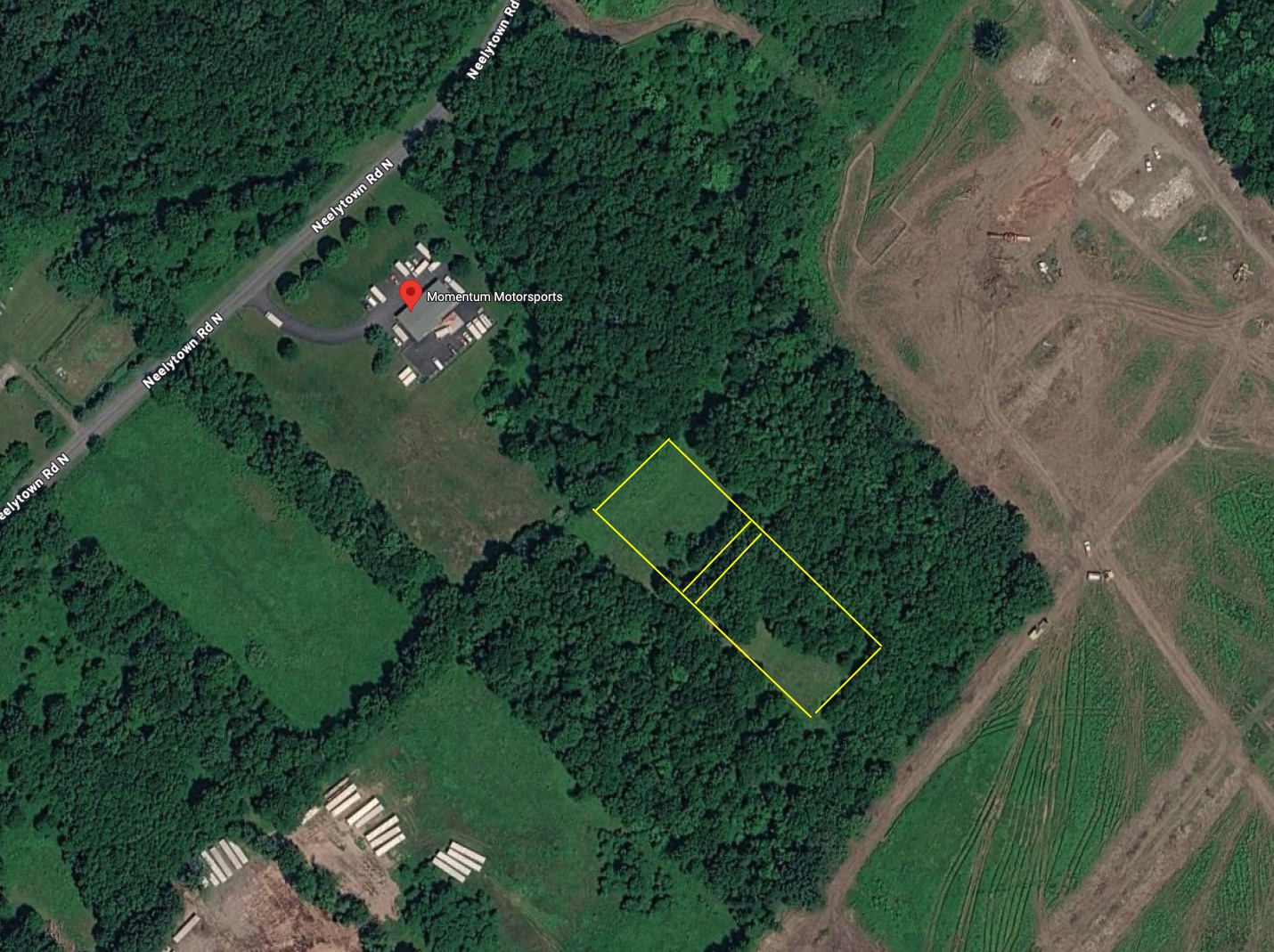

Aerial of the field site off Neelytown Rd N with the planned area outlined

Aerial of the site off Neelytown Rd N (near Momentum Motorsports). Yellow outline = the planned field area; the schematic below works out the row layout. Real dimensions still to be confirmed from a survey.

8′ deer fence — perimeter ≈ 1,000 LF N 10,000 gal water store pump · filter · fertigation skid Warehouse grow tents Prop house hoop + tables location vs. field: TBD main line (pressurized + fertigation) ↕ tractor aisle ~6′ between every row each bar = 10′ trellis · 2 plants across · pairs every ~5–6′ (●● = a pair) rows run ~200′ long · leave ~15–20′ headland at each end for the tractor to turn SCHEMATIC — not to scale. Field ≈ 250′ × 240′ (~1.2–1.4 acres incl. aisles), to be confirmed from site map.

Plant pairs are shown representatively, not counted one-for-one. Manifold dots (violet) sit at each row head where the main line feeds that row's drip sub-line.

3Project 1 — Warehouse & grow tents

Turn the existing dirty warehouse into a clean, climate-controlled room where clones recover under lights for their first days, and again briefly after up-potting.

Likely lead: Max Marco (teams w/ Max)
Owners likely but pending team discussion.
Order byThis week (Jun 1–7) — tents, LED, climate kit
BuildJun 1–14 — clean, assemble, light, climate
Ready by~Jun 14, before clones arrive

Build steps, in order

  1. Deep clean. Clear, sweep, wipe every surface, finish with a horticultural sanitizer on floors and walls. Young cannabis is highly vulnerable to mold and pests; a dirty room is the most common early killer.
  2. Set up grow tent(s) — reflective, sealed, controllable space inside the larger warehouse.
  3. Hang LED grow lights inside each tent.
  4. Add climate & air: humidifier, carbon filter + inline fan, oscillating fans, and a temp/humidity controller you can read and (ideally) monitor remotely.
  5. Stabilize and test the room for a day before plants arrive.

Climate targets — starting points to dial in

These are heuristics, not gospel The ranges below come from cultivation references and Athena Ag's published veg-stage protocol. They are a starting point. The grow lead must finalize them against our actual genetics, tent, and equipment, and adjust as the plants respond. Note: under LED, leaf surface runs ~2–5°F cooler than the air, so true VPD is a touch lower than an air reading suggests.
VPD = a combined temp + humidity comfort target; PPFD = light intensity at the canopy
StageTempHumidityVPDPPFDLight
Clone recovery (first days)70–78°F70–85%0.6–0.9 kPa100–250, ramp gently18h on / 6h off
Early veg (after up-pot)72–82°F58–75%0.8–1.0 kPa300–60018/6, blue-dominant

Sources (Jun 2026): Athena Ag veg-stage protocol (72–82°F, RH 58–75%, VPD 0.8–1.0, PPFD 300–600, LED 18–24″ off canopy); Blimburn / Pulse / MaryJane.farm for clone-stage ranges; Ed Rosenthal / Koolfog on LED leaf-temp offset. Treat as heuristics.

How many tents, and how big the kit?

Tent count is gated on the trays the clones ship in Clones are expected to arrive 25 cuttings per tray, so ~1,000 plants ≈ ~40 trays. Those trays need only short-term recovery space, packed fairly tight, before up-potting. Max confirms the exact tent count against the tray footprint before ordering. Equipment (lights, humidifier, fans, filter) must then be sized to the final tent count and tent volume — the quantities below are a starting frame, not a final order.
Equipment & ballpark cost — tap to expand
Rough planning estimates, Jun 2026. Confirm against final tent count + actual quotes.
ItemWhyQty (1,000 plants)Ballpark
Grow tent, 10′×20′Sealed, reflective recovery space1–2 (Max confirms)$2,000–2,500 ea
LED grow light (veg/clone grade)Low-to-moderate light for young plantsper tent coverage$400–1,500
Commercial humidifierClones need high humidity1–2$150–600
Carbon filter + inline fanAir exchange + filtration; sized to tent CFM1 per tent$150–400
Oscillating fansAirflow, stem strength, mold prevention2–4$100–300
Temp/humidity controller (remote-capable)Hold + monitor conditions; alerts1 per tent$80–250
Temp control (portable AC / heater / mini-split)Hold a stable rangeas needed$300–2,000
Cleaning + sanitizer suppliesDeep clean before plantsbulk$100–300
Project 1 subtotal (rough)~$3,300–11,000

Tent/LED prices: LED Grow Lights Depot, HTG Supply, Growers House (Jun 2026). Other items: commodity ranges, rough estimate — verify with quotes. Scales weakly with plant count; driven mostly by tent count.

Effort: roughly 40–70 person-hours, ~2 people, spread across week one (clean is the time sink; assembly and climate are fast). Estimate — refine with Max.

4Project 2 — Propagation house

A simple covered hoop tunnel right outside the warehouse where up-potted plants harden off — adjusting to real sun, wind, and outdoor air — before the field.

Likely lead: Max Marco (teams w/ Max) Structure/design input: Alec
Owners likely but pending team discussion.
Order by~Jun 6 — tunnel kit + shade cloth
BuildJun 8–18 — tunnel, tables, shade, fans, drip
Ready by~Jun 20, before plants leave warehouse

What it is

A hoop / caterpillar tunnel (curved steel bows, covered) sized to hold ~1,000 plants in 4-inch pots, with shade cloth over the top to cut harsh midday sun. Not a heated glass greenhouse — a fast, affordable shelter.

Pots must sit on tables — the ground is asphalt Asphalt gets dangerously hot in sun and will cook pots from below. Build simple tables (sawhorses + plywood/mesh, or pallet racking) to lift pots off the surface and let air move underneath. Non-negotiable; it is on the list.

How big? — sized generously on purpose

1,000 four-inch pots packed edge-to-edge cover only ~110 sq ft, but pots need walking room, table gaps, and airflow. Rather than size it tight, plan for breathing room:

ElementRecommended rangeReasoning
Table surface for pots~250–400 sq ft~2–3.5× the packed pot footprint, for spacing + airflow
Tunnel footprint~16′×40′ to 20′×50′ (≈640–1,000 sq ft)Leaves aisle + working room; err larger — extra space is cheap insurance against crowding and mold

Erring large here is deliberate: crowding young plants is a disease risk, and a bigger tunnel costs only a little more at ~$2–5/sq ft. The owner finalizes the size against the actual table build and site.

Equipment & ballpark cost — tap to expand
Rough planning estimates, Jun 2026.
ItemWhyFor 1,000 plantsBallpark
Hoop / caterpillar tunnel kit (incl. 6-mil cover)The structure~640–1,000 sq ft$1,300–5,000
Shade cloth (roof + ends)Prevents sun scorch on young plantssized to structure$150–600
Tables (sawhorse + ply/mesh or racking)Keep pots off hot asphalt~250–400 sq ft surface$300–1,500
Basic drip lines + timerWater trays without standing there1 small zone$150–500
Fertilizer-mixing setup (batch tank + measuring)Mix nutrients into the water1$100–400
FansAirflow, stem strength, mold prevention2–4$100–400
Project 2 subtotal (rough)~$2,100–8,400

Tunnel pricing: Farmers Friend ($1.77–2.02/sq ft kits), Bootstrap Farmer (<$5/sq ft built; 20′×100′ ~$1,600 kit), Jun 2026. Tables can be near-free from scrap lumber/pallets. Mostly fixed cost; does not scale much with plant count.

Effort: roughly 50–90 person-hours, ~3–4 people, ~3–5 days (tunnel raise + tables are the bulk). Estimate — refine with the leads.

5Project 3 — Irrigation & fertigation system

Get pressurized water — with nutrients mixed in ("fertigation") — from the 10,000-gallon store out to every one of the 1,000 pots, evenly and on a timer.

Likely lead: Alec Approach: Alec — quotes from Soilscape / RainFlo / Netafim
Alec raised and is the natural lead for irrigation; owner confirmation pending team discussion.
Engage / order byDesign this week; parts by ~Jun 9
InstallJun 8–22 — main, manifolds, sub-lines, emitters
Ready byBefore transplant — field watered & tested

What the system is (the "Pump & Delivery System")

This is more than a tank. It is a Pump & Delivery System sized to feed 1,000 drip emitters evenly. Its core parts:

  1. Pump — pulls water from the 10,000-gallon store and pressurizes it to a steady, regulated level.
  2. Filtration — protects the tiny drip emitters from clogging.
  3. Pressure regulation — drip irrigation runs at low, steady pressure; this holds it there.
  4. Nutrient injector — meters liquid nutrients into the water line (the "fertigation" part).
  5. Controller / timer — runs watering on a schedule, unattended.
  6. Captive-air / pressure tankAlec's read: likely not needed. It can smooth pump short-cycling and hose pressure, but include it only if the final design calls for it.

How the water reaches the plants

Pump & delivery skid → main line out to the field → a manifold (a junction) at the head of each row → a sub-line down each row → one drip emitter into each pot. About 16 manifolds, ~3,200 ft of sub-line, and 1,000+ emitters.

Irrigation: Alec is scoping the approach Alec has ideas on how to tackle this and is taking point. Plan: talk it through with Alec, then get quotes from Soilscape Solutions, RainFlo, and Netafim, and assemble a build/buy list. Sizing still has to be right — emitter flow, pipe diameter, manifold layout, and pump head against ~1,000 pots, possibly on a slope — or water is uneven and plants mature unevenly. Alec's read is we likely don't need a captive-air/pressure tank. Lock the approach this week so parts can be ordered.
Equipment & ballpark cost — tap to expand

Parts counts scale cleanly (1 emitter per plant, 1 manifold per row). Parts sizing (pump, pipe diameter, regulator) comes from the design. Treat the table as the shopping frame; the designer fills exact specs and firm prices.

Rough planning estimates, Jun 2026 — design-dependent. Alec's plan + vendor quotes (Soilscape / RainFlo / Netafim) govern.
ComponentWhat it doesFor 1,000 plantsBallpark
Pump + filtration + pressure regulationPressurize + protect emitters + hold steady pressure1 set, sized to design$800–3,500
Nutrient injector (fertigation)Mix nutrients into the water1$300–1,500
Controller / timerUnattended scheduled watering1included / $100–500
Main line + ~16 manifolds + sub-line (poly) + fittingsCarry + split water to rows~3,200 ft sub-line$1,000–4,000
Drip emitters + stakesDeliver water to each pot1,000+ (+ spares)$300–1,000
Captive-air tank (optional)Anti short-cycle / hose pressureAlec: likely skip$0–800
Project 3 subtotal (rough)~$2,500–11,000

Component ranges are commodity/market estimates, Jun 2026; the design quote replaces them. Sub-line and emitter counts scale linearly with plant count.

Effort: design is separate (designer + Alec). Install across 16 rows is the labor item: roughly 80–160 person-hours, ~3–4 people over several days, overlapping pot placement. Estimate — refine after design.

6Project 4 — The 45-gallon pot matrix

Place ~1,000 forty-five-gallon fabric pots in the field in the right pattern, fill them with soil, cap with mulch, and have them ready for the drip lines.

Likely crew lead: Max Marco (teams w/ Max) Tractor during fill: Alec All hands + surge labor
Owners likely but pending team discussion.
Order byThis week — soil + 1,030 pots
BuildJun 15–26 — place, fill, mulch, drip
Ready byBefore roots show (~Jun 24)

The layout — what we're actually trying to achieve

The goal is roughly 5′×5′ to 5′×6′ of space per plant — enough that mature plants in 45-gallon pots aren't crowded, which protects airflow and cuts mold risk. We reach that spacing logically with 10-foot-wide trellis rows holding two plants across the width (each plant gets ~5′ of the 10′), and pairs repeating every ~5–6′ down the length of the row. Putting two plants across each row means we need about half as many rows as planting single-file — less trellis, less drip line, less walking.

MeasureValuePlain meaning
Trellis / row width10 ft2 plants across, ~5′ apart
Spacing between pairs (down-row)~5–6 ftGives 5′×5′ to 5′×6′ per plant
Plants per 200-ft row~66 (at 6′) to ~80 (at 5′)Pairs × 2
Rows for 1,000 plants~13–16Baseline 16 at the airier 5′×6′
Tractor aisle between rows~6 ftSo a tractor + sprayer can drive every inter-row
Confirm the down-row spacing with Brett (Athena Ag advisor) This plan uses ~6′ between pairs as the airier baseline. Tightening to ~5′ fits more plants in fewer rows but reduces airflow. Confirm the target with Brett and against the real field width before the pot order is finalized — it sets the row count and the deer-fence length.

The soil — how much

A 45-gallon fabric pot holds about 6 cubic feet brim-full (27″ across × 18″ tall); we fill to ~85% ≈ 5.1 cu ft each. For 1,000 pots:

~5.1
Cu ft/pot (85% fill)
~5,100
Total cu ft (85%)
~190
Cu yd (1,000 × 6 × 85%)
~4
Truckloads (40–60 yd)
Confirm the pot's true fill volume before ordering soil "45 gallon" is a trade size and actual volume varies by ~10% between makers. We fill to ~85% (≈5.1 cu ft/pot) → ~190 cu yd for 1,000 pots; brim-full would be ~223. Confirm the maker's actual volume before ordering, and order a little long so you don't run short.

The fill method — Brett's proven system

This is the exact workflow Brett used to fill 45-gallon pots at volume. The key to speed is that the skid steer never stops moving.

StepAction
1Dump close. Each soil truck holds ~40–60 yd and dumps directly in the field, as near the crew as possible — about 4 loads for the ~190 yd. Closer dumps cut walking.
2Shuttle continuously. A car-hauler trailer is hooked to the farm truck; a skid steer runs non-stop between the soil pile and the trailer, keeping it loaded.
3Fill off the trailer. Truck + trailer inch forward down the row while the crew fills pots straight off the trailer with shovels.
4Mulch. Cap each filled pot with mulch so the soil doesn't bake and dry.
5Drip. Project 3's emitters get run to each pot.

Crew & time

Brett's experienced crew of 8–9 filled 1,500–2,000 pots per day, split as: 1 truck driver, 1 skid-steer driver, 2 setting pots in place, 5 shoveling.

Plan conservatively, and treat this as all-hands Brett described his best crew on a familiar site. Our crew is doing this for the first time, on a site being prepped at the same time, possibly in heat. Plan at 800–1,000 pots/day, not 1,500. This is the heaviest physical push of the build: it should be all hands on deck, plus vetted surge labor (see hiring standards). An extra crew-day is cheap; fill bleeding into the transplant window is not.
Plant countAt ~800/dayBudget (with margin)
8001 day2 days
1,000 (baseline)~1.25 days2 days
1,2001.5 days3 days
Equipment & ballpark cost — tap to expand
Rough planning estimates, Jun 2026. Soil is the dominant line and the biggest variable.
ItemFor 1,000 plantsPer-plant rateBallpark
45-gal woven fabric pots1,030 (+3% spare)1.03$4,600–8,200
Soil — bulk organic blend (by the yard)~190 cu yd0.19 cu yd$9,500–28,500
Mulch (cap layer)all pots, depth TBDper pot top$200–1,000
Skid steer (rental if not owned)1, ~2 days$0–1,000
Car-hauler trailer + farm truck1 eachowned / $0–300
Shovels + hand tools5–6$100–300
Surge labor (beyond owners)~4–5 hands × 2 days$1,300–3,000
Project 4 subtotal (rough) — soil-driven~$15,700–41,800
Soil grade is the single biggest swing in the whole budget A bulk organic blend by the yard runs roughly $50–150/cu yd delivered; a premium bagged/living-soil mix can hit ~$218/cu yd — which would roughly double the soil line to ~$41k. At ~190 yards, the sourcing decision is worth more than $20,000. Sourcing is set: Vermont Compost and McEnroe (both quoted). Schedule delivery now — lead time can run 2–3 weeks against the Jun 24 transplant, so it's on the critical path. Confirm whether the blend is container-ready or needs amending for cannabis. [Pricing: Rock Pile, Got Mulch, Soil3, Home Depot bagged ceiling, Jun 2026 — estimate, get quotes.]

Pots: 247Garden / HTG / GrowGeneration bulk pricing ($4.28–6.48+ ea), Jun 2026. Pots and soil scale linearly with plant count; equipment is fixed.

Effort: the fill itself is ~140–160 person-hours (8–9 crew × ~2 days), plus pot placement and drip hookup. The all-hands day(s). Estimate — refine with Max + Brett's guidance.

7Trellis, tractor access, deer fence & cold-frame option

The field infrastructure around the pots: what holds the plants up, how the tractor gets through, what keeps deer out, and whether to plan for late-season rain protection.

Likely: Max + Marco (trellis/fence), Alec (tractor, layout)
Owners likely but pending team discussion.

Trellis & tractor access

Each 10-foot-wide row is trellised to support the plants. Critically, we want a ~6-foot aisle between every row so a tractor with a mounted implement can drive each inter-row — for spraying (a tractor-mounted sprayer), mowing, and general work. Leave ~15–20 ft of headland at each row end for the tractor to turn. Aisle width should be confirmed against the actual tractor + implement before rows are pegged out.

Tall posts & the cold-frame question

An option worth weighing now: driving in tall posts (~12 ft) along the rows that serve double duty — trellis support and a frame to pull plastic over the plants late in flower if heavy rain threatens. Covered ("cold-frame") outdoor plants often finish cleaner, because keeping rain off dense late-season flower is one of the best defenses against bud rot.

Honest constraint on "12-foot posts" Standard steel T-posts top out around 8–10 ft and aren't built to anchor plastic against wind. A true 12-ft cover frame means heavier driven posts (e.g., ground-driven pipe or greenhouse-grade posts) with cross-bracing — more cost and labor than a plain trellis. The team should decide between three options below; the owner finalizes.
OptionWhat it givesTrade-offRough cost
Plain trellis onlyPlant supportNo rain protection late season$2,000–6,000
Tall posts now, plastic only if neededSupport + the option to coverHeavier posts up front; plastic bought later+$1,000–3,000 over plain
Full cold-frame coverSupport + rain protection + cleaner finishMost cost/labor; wind management+$1,000–5,000 over plain

Costs rough, Jun 2026 — confirm with a structures quote. The middle option (tall posts now, plastic on standby) is often the sensible hedge: low extra cost, keeps the door open.

Deer fence

A perimeter deer fence (~8 ft tall, ~1,000 linear feet) protects the entire crop — deer can destroy an outdoor planting fast and jump short fences. Put a temporary hot-wire or mesh up before transplant if the permanent fence isn't finished.

Rough planning estimates, Jun 2026.
ApproachPer foot~1,000 LFNote
DIY woven-wire / poly mesh, 8 ft$2–6$2,000–6,000Farm labor does it; most cost-effective
Professionally installed$5–12$5,000–12,000Faster, higher upfront

Deer-fence pricing: HomeGuide, dtefence, Angi, Design Transition Studio (Jun 2026). Scales with perimeter, which scales with field size/row count.

8Spray program & plant health

A plan for keeping plants healthy with sprays that are legal in New York cannabis, organic-approved, and safe for resin quality and extraction.

Likely: Alec (plant health) with Athena Ag protocolSteven (crop nutrition monitoring)
Brett & Owen at Athena Ag are advisors on nutrient and pest/disease program; owners pending team discussion.
Compliance gate — read before buying any product In New York cannabis, a spray being "organic" or OMRI-listed is necessary but not sufficient. It must also be on the list of pesticides the Office of Cannabis Management (OCM) allows for cannabis, every application must be logged in our inventory tracking system, and residues must pass the OCM testing panel — some products (e.g., myclobutanil) trigger automatic batch failure. Do not treat any product as approved until it is verified against the current OCM list and our advisor's protocol. This document gives the framework, not a cleared product list.

How to build the actual list (the gate every product passes)

  1. OMRI-listed — organic-approved active.
  2. OCM-allowed for NY cannabis — on the state's permitted list for cannabis cultivation.
  3. Extraction- & resin-safe — nothing that taints flavor/aroma or concentrates through extraction and shows up on a COA.
  4. Athena Ag protocol fit — consistent with our advisors' program.
  5. Logged — every application recorded in inventory tracking, with rate and date.

Program shape (fill products after verification)

ModePurposeTypical organic categories to verify
Preventative (scheduled)Stop problems before they start — the bulk of the programBiological fungicides (e.g., Bacillus-based), neem/azadirachtin-type botanicals, beneficial insects/biocontrols, foliar plant-health inputs — each to be confirmed OCM-allowed
Reactive (as-needed)Knock down a specific pest or disease on detectionTargeted OMRI insecticidal/fungicidal actives matched to the diagnosed problem — confirmed OCM-allowed and extraction-safe
Build deliverables (next, with the advisor) (1) A dated preventative spray calendar — what, when, at what rate, through the season. (2) A reactive playbook — "if you see X, do Y," with the specific verified products and rates. (3) A materials + cost list for both. All gated on the OCM-list + Athena verification above.

Application equipment

A tractor-mounted sprayer lets one person cover the field quickly. A standard 60-gallon 3-point-hitch unit with pump and boom runs roughly $700–1,800.

Important: spec the nozzles for tall canopy, not turf Off-the-shelf 3-point sprayers ship with flat broadcast booms meant for turf/row crops — a horizontal swath. Tall cannabis needs vertical / directed application (drop nozzles or a vertical boom, or the handgun) to coat the canopy top-to-bottom. The right nozzle configuration needs grower input before purchase. [Sprayer pricing: Tractor Supply, Home Depot, Farm & Home Supply, Jun 2026 — estimate.]

9Genetics selection

Which plants we run matters as much as how we grow them. For NY outdoor, the genetics should be chosen to survive a wet Northeast finish and beat the frost.

Likely: Max + advisors, against the criteria below
Final cultivar selection pending genetics-source conversation and Athena Ag input.

Prioritize cultivars by these traits, in roughly this order:

  1. Disease resistance — especially Botrytis (bud rot) and Septoria (leaf spot), the two that punish a wet Northeast fall. Favor structures that are dense-but-airy, not tight and moisture-trapping.
  2. Early finish — cultivars that mature in late September / early October, before hard frost and the worst rain. A late-finisher can lose the crop to weather regardless of how well it's grown.
  3. Proven outdoor / Northeast performance — vigor in shorter seasons and cooler nights.
  4. Market fit — potency, aroma, and yield that the brand and buyers want.
Verify resistance claims — don't take marketing at face value Breeder "mold-resistant" labels vary widely in reliability. Vet candidate cultivars against these criteria with the genetics source and Athena Ag, and lean on local Northeast outdoor track record where it exists, before committing the order.

10People, hours & hiring

Who does what (likely, pending discussion), roughly how much labor each project takes, and the standard we hold for anyone we bring on.

Likely owners by function (pending team discussion)

PersonLikely scope
MaxPrimary on most things. Leads the grow tents and the care of the plants; crew lead on the pot fill. Marco teams with him across these areas.
MarcoHead of Resin Quality Management — monitors resin-head (trichome) development through flower and advises on harvest timing. Works with Alex to optimize the fresh-frozen operation (cut→freeze window). Teams with Max on grow tents, prop house, and the fill.
AlecLeads irrigation (he raised it and is scoping the approach; quotes from Soilscape / RainFlo / Netafim). Also: water test, greenhouse/structure design input, tractor driving during the fill, plant health, and setting up cameras, sensors, and remote data/monitoring.
StevenRemote monitoring & crop nutrition — watches the remote sensor feeds (tent/prop climate, field soil-moisture) and the plants’ nutritional status (tissue-test results, fertigation EC/pH), flagging drift early. Partners with Alec on the data side and Athena Ag on the feed program.
Athena Ag (Brett & Owen)Advisors — nutrient and pest/disease protocol, fill-system guidance, spacing. Not on-site owners.

Rough labor by project

Estimates to size the crew — refine with the leads. Several projects overlap in time.
ProjectPerson-hoursPeopleWindow
P1 · Warehouse + tents~40–702Week 1
P2 · Prop house~50–903–4Weeks 1–2
P3 · Irrigation install~80–1603–4Weeks 2–4
P4 · Pot fill (all hands)~140–1608–9Weeks 3–4
Trellis + deer fence~60–1202–4Weeks 1–4

Hiring standard — for every role, even part-time

Only great people — mediocre hires cost us the time of our best people We are looking for additional part-time coverage, but the bar stays high even for lower-level seasonal roles. A weak hire doesn't just underperform — they pull our strongest people off their work to manage, correct, and redo. Be deliberate and selective. A smaller, excellent crew beats a larger, uneven one.

11Security, monitoring & data

Protecting the crop physically, watching conditions remotely, and being disciplined about who knows what.

Likely: Alec (cameras, sensors, data)Steven (remote monitoring & crop nutrition)
Owner likely but pending team discussion.

Get up before plants are in the ground

Rough planning estimates, Jun 2026 — verify with quotes.
ItemBallpark
Security camera system (4–8 cams, cellular/solar if needed)$300–2,000
Environmental sensors (tents/prop) with remote alerts$100–800
Soil-moisture sensors (field) with remote readout$100–1,000

Visitors & information discipline

Approve everyone; share narrowly Any part-time labor, helper, or visitor must be approved before they're on site. Be thoughtful about what information is shared with whom — site details, security setup, genetics, volumes, and timing are sensitive. Default to sharing only what someone needs for their specific role.

12Equipment list & budget

The per-project equipment tables above are the full purchase list. This rolls them into one budget. Items that scale with plant count are noted.

Read the numbers honestly These are rough planning ranges from web research dated June 2026, not quotes. They exist to size the budget and spot the big swings, not to commit dollars. Each owner confirms real pricing before purchase. The total range is wide mostly because of one line: soil.
Budget roll-up — rough ranges, Jun 2026.
LineBallpark rangeScales with plants?
P1 · Warehouse + grow tents$3,300–11,000Weakly (tent count)
P2 · Propagation house$2,100–8,400Weakly (mostly fixed)
P3 · Irrigation & fertigation$2,500–11,000Yes (emitters, sub-line)
P4 · Pot matrix (pots + soil + fill)$15,700–41,800Yes — soil & pots linear
Trellis + tractor access$2,000–6,000Yes (row count)
Deer fence (~1,000 LF)$2,000–12,000Yes (perimeter)
Cold-frame option (if chosen)$0–5,000Yes (row count)
Tractor-mounted sprayer$700–1,800No
Cameras + sensors$500–3,800No
Clones (~1,000 @ ~$10)~$10,000Yes (linear)
Indicative total (excl. reefer, already committed)~$38,800–110,800
What drives the spread The gap between the low and high total is mostly: soil grade (bulk blend vs. premium), deer fence (DIY vs. installed), and irrigation scope. Nail the soil quote first — it moves the total more than anything else. The clone line (~$10,000) is a prior placeholder to confirm against an actual quote. The reefer is already a committed purchase and is not in this scope.

13Most likely ways this goes wrong

Named honestly and in order of likelihood, with the move that prevents each. Awareness is the cheapest insurance.

#Failure modeWhy it's likelyPrevention
1Timeline slip — field not ready when roots showFour parallel builds + long-lead orders + a hard biological deadlineOrder the week-one list now; protect the critical path (design → soil → fill → drip); pad the fill to 2 days
2Watering failure — uneven or interrupted water1,000 emitters on one system; a pump or clog fails silentlyUse a designer; filtration; controller with alerts; soil-moisture sensors; daily checks
3Disease in a wet finish — botrytis / septoriaNortheast fall is humid and rainy; dense flower traps moistureAirflow-first spacing (5′×6′), resistant + early genetics, preventative spray calendar, cold-frame option on standby
4Bottleneck breaks the plant flow — heat on asphalt, fill jams, clone qualityAsphalt cooks pots; first-time fill crew; clones can arrive weakTables off asphalt + shade cloth; conservative fill plan + all-hands; inspect clones on arrival, isolate anything suspect
5Security / labor — theft, deer, or a weak hireHigh-value outdoor crop; seasonal hiring pressure; open siteDeer fence + cameras before transplant; high hiring bar; approve all visitors; share information narrowly

14Open decisions to confirm

The holes. None are papered over with guesses. Each needs an answer to lock the plan.

  1. Team go/no-go & commitment. Get everyone on a call to confirm comfort with the plan, individual roles, time commitment, availability, and that the project is feasible before committing spend. Do first.
  2. Irrigation approach — Alec to lead/scope. Discuss with Alec, then get quotes from Soilscape, RainFlo & Netafim and assemble the build/buy list. Captive-air/pressure tank: Alec's read is not needed. Lock this week.
  3. Down-row spacing — ~5′ or ~6′ between pairs? Sets row count (13–16) and fence length. Confirm with Brett + against real field width.
  4. Real field dimensions. Provide the marked-up site map so the drawing, row count, and fence length go to scale (area may be wider than older images show).
  5. Grow-tent count. Confirm against the 25-per-tray clone shipment (~40 trays). Gates the tent + kit order.
  6. Soil delivery. Vermont Compost + McEnroe quoted — book delivery now (2–3 wk lead vs the Jun 24 transplant). Confirm container-ready vs. needs amending. Biggest budget swing.
  7. Pot vendor & true fill volume. Confirm the maker's actual volume (trade-size varies ~10%) before the soil order.
  8. Trellis / cold-frame choice. Plain trellis, tall posts on standby, or full cover.
  9. Spray list. Verify products against the OCM-allowed list + Athena protocol + extraction safety; then build the calendar + reactive playbook.
  10. Genetics. Select resistant, early-finishing cultivars with the genetics source + Athena.
  11. Clone arrival date (~Jun 15–18). The whole timeline anchors to it — confirm with the supplier.
